Hello everyone!
This is James - I’m leading product development here at Terrashroom.
- I can give some explanations on hangups & what’s been going on from a more technical perspective.
- Provide an accurate manufacturing timeline so you're informed of where we are currently.
- Share how close we are to shipping product out.Â
This is going to be a beast of an email loaded with tons of info, so buckle up & grab some popcorn.
What have we been doing for the past 6 months?
To give some background context, here’s the 30-second story of Terrashroom to help understand what’s been going on.Â
Prototyping terrashroom started in early 2022.Â
- Contractors would promise product completion by June 2022.
- Jared would relay these "launch" dates to customers with this info.
- The contractors would then push back deadlines (to get additional billable hours)
- The launch would get pushed back & Jared would then share the bad news.Â
Product development timelines
Bringing a newly invented consumer electronics product to life takes a lot of work, revisions, and money. Generally, it takes about 2+ years.Â
-MasterCAD is complete
-Firmware complete
-App is done + software complete
-PCB, circuitry, + electrical systems complete
What's the timeline for manufacturing + shipping terrashrooms?
Â
-

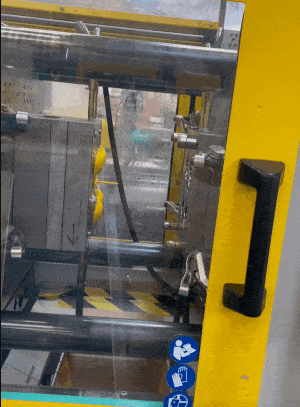

Injection mold tooling (begins first week of September)
- This week we start the tooling process. This is where giant steel molds are cut & this process takes roughly 6 weeks from start to finish.Â
-
T1 manufacturing samples (early-mid October)
- The first injection-molded samples produced from these molds will come in the middle of October. Usually these first samples need to be tweaked slightly to ensure quality.Â
- Jared and I are flying to the manufacturing plant to keep things running smoothly & have an eye on this process.Â
-
First assembly + product QA testing (end of october)
- Assembly and testing of the first produced units will occur at the end of October or beginning of November.Â
-
First manufacturing run (middle November)
- We will start producing these & immediately have them shipped out via air freight (~10 days) to our warehouse in Austin, Texas.Â
-
Target ship date (end of November - December)
- We will then ship product out to customers immediately afterwards, to be delivered before Christmas!
Â
Things don't always go according to plan, so we've identified some potential risks that may cause delays:
-
Delays in the supply chain for the internal components.
- These internal components are the fans, circuits, and other electronics that make the magic happen! Sometimes there are delays in the suppliers of these parts, so we are pre-ordering them now to prevent delays during the manufacturing process.Â
-
Errors in tooling for injection molds.Â
- Tolerances, component mating, & other small details can hold things up. Luckily, we are working with an incredible manufacturer who has shipped millions of consumer electronic products & will help prevent these issues from coming about.
-
Resurgence of covid causing import delays
- We don't think this will be a problem, but we're willing (somewhat jokingly) to charter our own private boat/plane to transport product if absolutely necessary.Â
